A Revit schedule is not an ordinary static table you type into. It is a live, bidirectional window into your BIM database: doors, rooms, structural framing, areas, finishes, and drawing sheets. This comprehensive guide details how to create a schedule in Revit (updated for Revit 2027), configure multi-level sorting, add custom calculated values with dimensional accuracy, format sheets for printing, and export clean data to Excel.
⚡ 30-Second Quick Answer

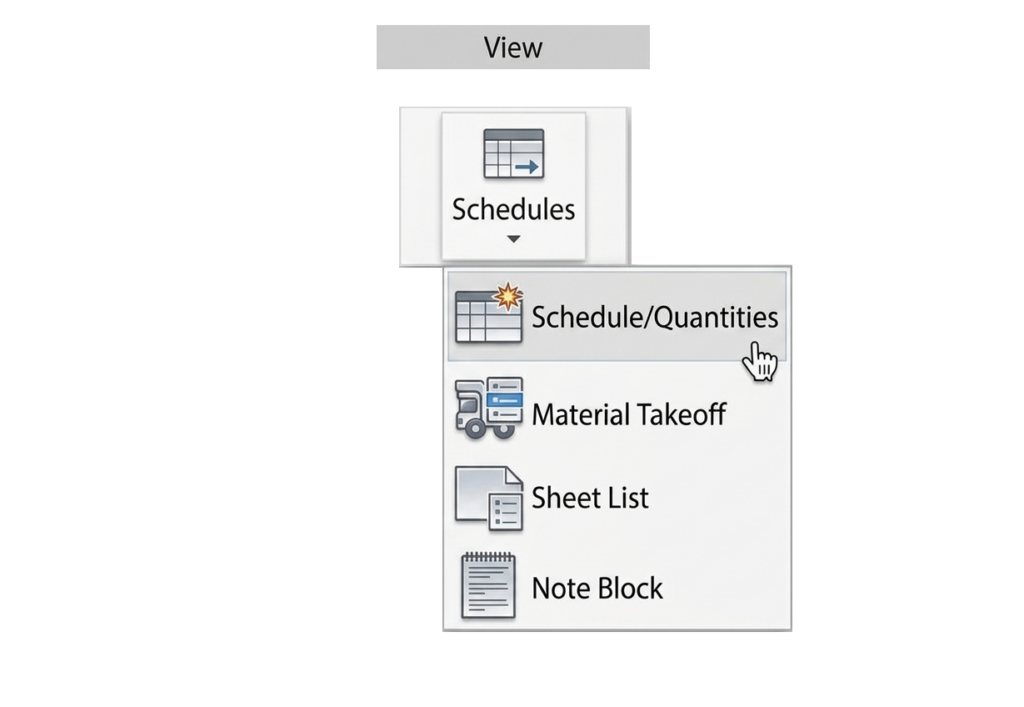

To create a schedule in Revit: Open the View tab > Create panel > Schedules > Schedule/Quantities. Select your category (e.g., Doors, Rooms, Walls), click OK, move your desired parameters into Scheduled fields, and click OK.
Revit instantly compiles a live database view. Changes in the schedule update the model immediately, and deleting or editing geometry in plan updates the schedule automatically.
Part of the Free Course • Module 06
Documentation and Communication
Schedules are the cornerstone of contract deliverables. Discover how to combine schedules, sheet lists, revisions, and automated tag legends into a coordinated tender package.
Open Module 06 in the Free Course
Want the multi-trade RVT practice model to follow along? Download the tutorial files ($5.5/month on Patreon).
What Is a Schedule in Revit? (The Bidirectional Truth)
A schedule in Revit is not a disconnected drawing or spreadsheet table. It is a live tabular view of the Building Information Model, governed by the exact same database engine that powers your floor plans, elevations, and 3D views.
Because the database is bidirectional, edits flow both ways:
- Model to Schedule: Delete an interior door in the Level 2 floor plan, and its corresponding entry instantly vanishes from the door schedule.
- Schedule to Model: Change a door’s fire rating from 20 Min to 60 Min inside the schedule table, and the underlying family instance in the model adopts that parameter value in real time.
Manual tables assembled in Excel become outdated the moment an architect shifts a wall or adjusts a structural column grid. A native Revit schedule never falls out of sync.
Types of Revit Schedules
Revit features nine specialized schedule types under View tab > Create panel > Schedules. While 90% of architectural workflows utilize the first three, selecting the correct schedule type prevents data loss:
| Schedule Type | What It Lists | Common Output |
|---|---|---|
| Schedule/Quantities | Individual building components belonging to one category (doors, windows, walls, rooms, casework). | Door & Window Schedules |
| Material Takeoff | Individual material layers within assemblies, calculating surface areas and solid volumes. See our detailed guide on how to create a BOQ in Revit. | Concrete & Masonry BOQ |
| Sheet List (Drawing Index) | All sheets created across the project, including issue dates, revisions, and approval statuses. | Cover Sheet Drawing List |
| Key Schedule | Predefined schema keys that automatically populate groups of instance parameters (e.g., room finishes). | Room Finish Standards |
| Note Block | Lists generic annotation symbols, tags, and numbered plan revision notes. | Numbered Plan Keynotes |
| View List | Comprehensive directory of every plan, section, callout, and 3D view in the project file. | BIM Audit & QA/QC |
| Revision Schedule | Internal delta list embedded directly within a title block family to document delta triangles. | Titleblock Revisions |
| Panel & Column Schedules | Dedicated electrical panel load balancing sheets and graphical structural column tie elevations. | MEP & Structural Sets |
How to Create a Schedule in Revit (Step by Step)
Below is the step-by-step procedure to generate a standard commercial Door Schedule. The same workflow applies to windows, plumbing fixtures, structural framing, or furniture.
- Go to View tab > Create panel > Schedules drop-down > Click Schedule/Quantities.
- Choose the Category: In the New Schedule dialog, scroll to and select Doors.
- Verify Phase: Confirm that the Phase dropdown matches the elements you want to capture (e.g., New Construction). If your phase is set to Existing, newly modeled doors will not populate.
- Click OK.

Revit generates the table and lists it under Schedules/Quantities in the Project Browser.
To modify your schedule settings later, open the schedule view and examine the Properties palette. You will find five distinct Edit… buttons corresponding to the five core property tabs.
Revit 2027 Tip: Modern Revit releases include automated, rule-based mark numbering. If you establish automatic numbering patterns on doors, the Mark parameter synchronizes across your floor plans, tags, and schedule tables automatically.
Schedule Properties in Revit: The Five Tabs Explained
| Property Tab | Primary Function | Critical Setting Most People Miss |
|---|---|---|
| Fields | Controls which parameter properties appear as columns; hosts Calculated Parameters (fx). | Include elements in links checkbox at the lower-left corner for linked consultant models. |
| Filter | Restricts rows using comparative criteria (e.g., Level equals “Level 1”). | You can only filter by a field that is added to the Scheduled fields list. To hide it from view, designate it as a Hidden field under Formatting. |
| Sorting/Grouping | Establishes visual row hierarchy, footers, headers, blank lines, and grand totals. | Itemize every instance: Unchecking this compresses hundreds of identical elements into single consolidated rows. |
| Formatting | Sets column headings, cell alignments, custom decimal precision, and conditional color overrides. | Calculate totals: Numeric fields (Area, Volume, Cost) default to “No calculation” and will display blank footers until switched to Calculate totals. |
| Appearance | Manages table borders, grid lines, text typography, and row zebra-striping. | Appearance settings only render when the schedule is placed onto a Sheet. The active schedule view remains a plain system grid. |
Count Each Door Type in Four Clicks
Transforming an itemized list of hundreds of doors into a concise procurement summary takes seconds:
- In Schedule Properties, open the Fields tab and add the Count field.
- Switch to the Sorting/Grouping tab and set Sort by: to Family and Type.
- At the bottom of the tab, uncheck “Itemize every instance”.
- Switch to the Formatting tab, select Count, and set its alignment to Center.
Each door type now condenses into a single row displaying the total quantity installed across the project.
Revit Schedule Formatting
Formatting is managed on a per-column basis. Open Properties > Formatting tab, choose a parameter from the left, and fine-tune its behavior on the right:
- Heading Label: Renames the column header on sheets without altering the underlying parameter name in your family library. (e.g., rename Family and Type to Door Type Designation).
- Heading Orientation: Rotates column header text 90° vertically, saving space for narrow boolean columns on paper sheets.
- Alignment: Left-align descriptive text; right-align numerical values (dimensions, areas, currencies) so decimal places align cleanly.
- Field Format: Uncheck Use project settings to override project units for that column alone (e.g., displaying room areas in integer m² while retaining two decimals elsewhere).
- Hidden Field: Keeps a parameter active for internal sorting, formulas, or filters while hiding the column from the printed sheet.
Ribbon Formatting Tools: When viewing a schedule, highlight multiple column headers in the table and click Group on the ribbon to create a merged super-heading (e.g., placing a single Rough Opening Dimensions header spanning across Width and Height). Click Freeze Header to keep top headings pinned while scrolling through thousands of components.
Conditional Formatting in a Revit Schedule
Conditional formatting highlights modeling oversights by applying background color alerts when parameter values cross specified rules:
- Open the schedule and click Edit… next to Formatting in the Properties palette.
- Select your target field (e.g., Width or Area).
- Click the Conditional Format button.
- Set your logical evaluation: Test: Less than, Value:
900 mm(for egress door clearance verification). - Select a high-visibility background color swatch (such as soft red or amber) and click OK.
To print conditional fills on physical titleblocks, check Show conditional format on sheets under the Formatting tab. Leave it unchecked if you only want color coding as an internal QA/QC audit view.
Calculated Values in a Revit Schedule
A Calculated Parameter evaluates live formulas across existing parameter columns. Click the Add calculated parameter button (fx) on the Fields tab to configure your equations.
Here are three high-utility formulas used on professional projects. Click to copy each formula directly into your Revit parameter configuration dialog:
Three Golden Rules for Calculated Parameters:
- Field Dependency: A formula can only compute fields that already exist in your scheduled fields list. Add the parameter first, then hide the column if needed.
- Case Sensitivity: Field references are strict:
widthwill trigger a syntax error; it must matchWidthexactly. - Inconsistent Units Check: If multiplying length by length, your result type must be designated as Area. If dividing area by area, set the type to Number.
How to Create a Room Schedule in Revit
Room schedules summarize architectural spatial programs. You must have rooms placed in your model (or study our detailed guide on rooms and room tags in Revit).
- Go to View tab > Schedules > Schedule/Quantities and choose Rooms.
- Add Level, Number, Name, and Area. Add Department or Occupancy if calculating spatial loads.
- Under Sorting/Grouping: Sort by Level, check Footer (select Title, count, and totals), then sort by Number. Check Grand totals.
- Under Formatting: Select Area and change calculation to Calculate totals.
Audit Your Area Column: Before submitting numbers to a client or building official, audit these three error flags in your Area column:
- Not Placed The room entry exists in the project database but was deleted or detached from the physical plan view.
- Not Enclosed The room has an unsealed perimeter gap in its walls, room boundary lines, or separation edges.
- Redundant Room Two room volumes are placed overlapping within the exact same closed perimeter boundary.
Early Briefing Trick: Use Insert > Data Row on the ribbon to populate your client’s spatial brief into the schedule before drawing walls. As design progresses, pick these pre-numbered unplaced rooms from the options bar and drop them straight into your floor plan.
Revit Area Schedule vs. Room Schedule
Rooms measure internal usable boundaries up to wall finish faces. Area Schemes measure legal lease areas, gross external footprint (GEA), or local zoning splits independent of internal wall partitions.
- Generate an Area Plan: Open Architecture tab > Area drop-down > Area Plan. Select Gross Building or Rentable.
- Delineate Boundaries: Sketch boundaries using Area Boundary Line, then place zones using the Area tool.
- Create Schedule: Open Schedule/Quantities and choose Areas (Gross Building) or Areas (Rentable). Each area scheme is listed as its own distinct category.
- Add Level, Name, and Area.
- Uncheck Itemize every instance under Sorting/Grouping to produce an executive one-line total gross floor area per building level for municipal planning reviews.
Furniture Schedule (Room-Aware Schedules)
A frequent scheduling requirement is tracking components by the specific room they occupy (e.g., FF&E furniture lists, sanitary fixtures per bathroom, light fixtures per office):
- Create a Schedule/Quantities for the Furniture category.
- Add Family and Type, Count, Manufacturer, and Cost.
- Change the Select available fields from dropdown from Furniture to Room.
- Add Room: Number and Room: Name.
- Sort by Room: Number, then by Family and Type, and uncheck Itemize every instance.
If a component shows a blank Room value, the family’s insertion point is sitting outside the 3D room boundary volume, or its Room Calculation Point is disabled inside the family editor.
Include Elements from Linked Files in a Schedule
Large projects separate architecture, structure, and MEP into linked RVT files. By default, Revit ignores linked files in schedules, resulting in structural columns or MEP fixtures showing an empty count.
- In Schedule Properties, open the Fields tab.
- Check the box for Include elements in links at the lower-left corner.
- Switch Select available fields from: to RVT Links and add RVT Link: File Name.
- Click OK. Elements from external models will instantly integrate alongside host data.
Four Rules for Linked Schedules:
- Read-Only Entries: You cannot modify linked instance parameters inside the host schedule. Edits must occur inside the source link.
- Filter Limitations: With linked models enabled, filtering by Family, Type, or Level can become restricted in certain schedule categories.
- Filter by Source Model: Filter by RVT Link: File Name to isolate elements from a single linked building block (Autodesk Knowledge Network).
- Double-Counting Warning: If columns or grids were duplicated using Copy/Monitor, unticked link filters will double your quantities. Always cross-check counts by sorting by link file name.
Find a Schedule Row in the Model (Highlight in Model)
When reviewing hundreds of schedule rows and discovering an anomaly in row 48, do not spend time hunting manually through dozens of plan sheets:
- Click any cell in the target row within your schedule.
- On the ribbon’s Modify Schedule/Quantities tab, click Highlight in Model.
- Revit automatically opens a matching view, zooms to the element, and selects its bounding box.
- Click Show to cycle through other representations (plan, section, 3D), then click Close.
Power-User Shortcut: Press WT (Tile Windows) to place your schedule side-by-side with your active floor plan. Selecting a row in the schedule instantly highlights the corresponding 3D geometry in the plan without closing the schedule (Autodesk Official Documentation).
Placing and Splitting Schedules on Sheets
- Placement: Open your target sheet view and drag the schedule from the Project Browser straight onto the sheet canvas.
- Adjust Column Widths: Click the schedule on the sheet and drag the small blue triangle handles above each column boundary. Column widths adjusted on sheets do not alter your schedule view layout.
- Split on One Sheet: Click the small zig-zag break icon along the upper right perimeter to split a long schedule into side-by-side columns.
- Split Across Multiple Sheets: In the schedule view, click Split & Place on the ribbon. Select your desired sheets, establish row height segments, and place them across your drawing set in matching sheet coordinates.
Send a Revit Schedule to Excel
Revit exports schedule reports as delimited plain text, which connects directly into Excel without needing extra tools:
- Open the schedule so it is your active workspace view (the export command remains disabled in drawing views).
- Go to File > Export > Reports > Schedule.
- In the dialog, set Column headers to One row, and set the Field delimiter to Tab (commas often cause errors because they appear within family names).
- Open Excel and select Data > From Text/CSV to import your clean tab-delimited file.
Looking for live bi-directional synchronization where edits in Excel write back to Revit parameters automatically? See our complete tutorial on how to export Revit schedules to Excel.
Interactive Troubleshooter: Why Is My Schedule Wrong?
Click on the symptom below to reveal the cause and its immediate technical fix:
Fix: Open Schedule Properties > check the Phase dropdown at the bottom. If your model is drawn in “New Construction” and the schedule is set to “Existing”, zero elements qualify. Next, open the Filter tab and clear all criteria. Finally, if elements are in linked models, enable Include elements in links under the Fields tab.
Frequently Asked Questions
How do I make a schedule in Revit?
Where are schedules located in Revit?
How do I create a room schedule in Revit?
How do I create an area schedule in Revit?
How do I add a calculated value to a Revit schedule?
Width * Height).How do I use conditional formatting in a Revit schedule?
How do I include elements from linked files in a Revit schedule?
Can I export a Revit schedule directly to Microsoft Excel?
